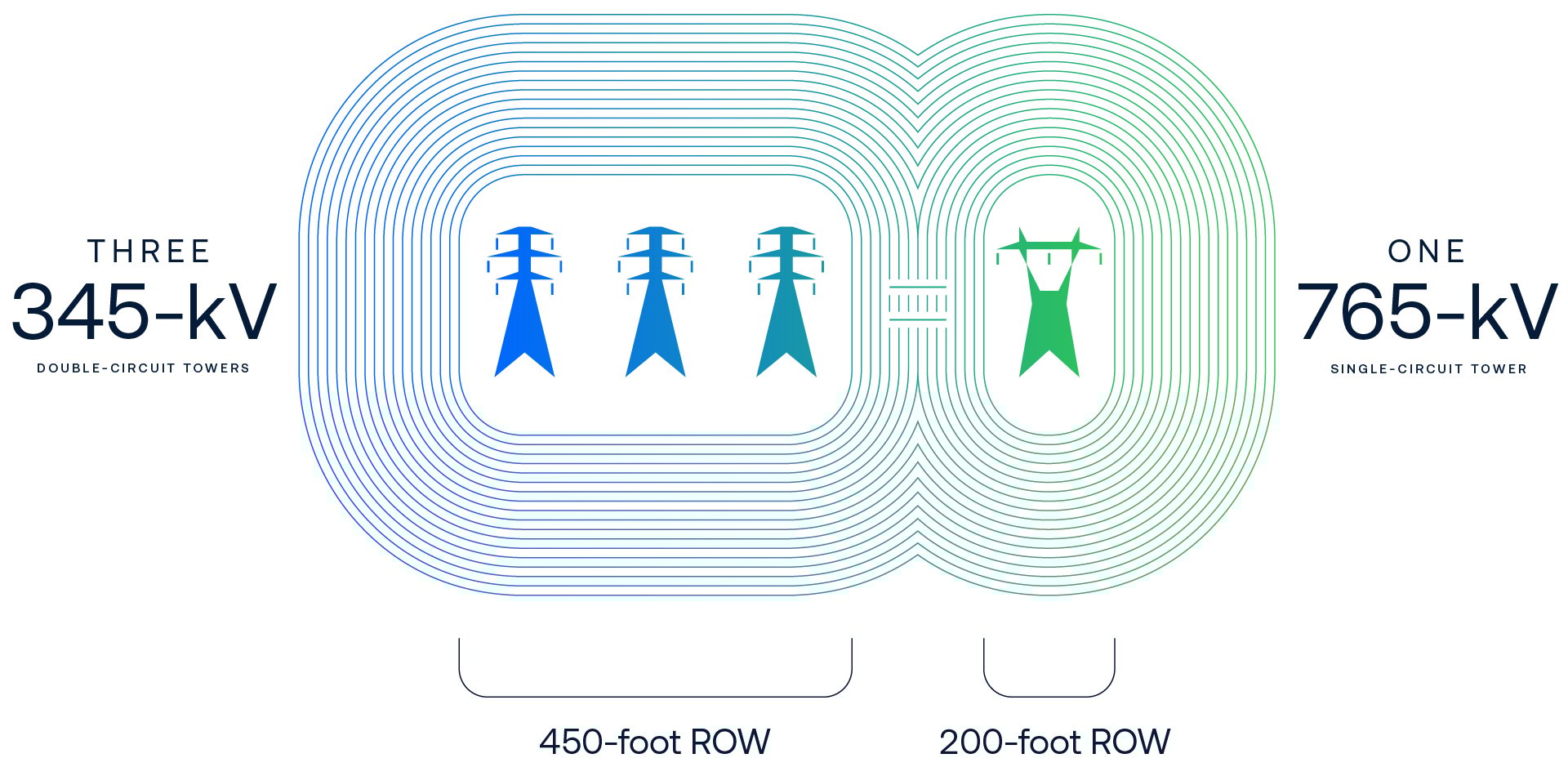

This was a critical factor when the Public Utility Commission of Texas weighed the technology against 345-kV for the Permian Basin challenge. Although the commission found 765-kV to be the more expensive option, it would offer far more capacity and stability. Put another way, value trumped cost. Of greater importance was whether 765-kV could be deployed by the same deadlines previously sought for 345-kV lines; Texas regulators determined it was possible.
“Those advantages outweighed the difference in price,” Hancock says. “It wasn’t that 765-kV was the cheapest option, it was just the overall best option.”
The higher-voltage technology also offers efficiencies like lower line losses and fewer intermediate substations needed as it forms a spine to enable large-scale power sharing.
The concept of a broad 765-kV transmission network is not new. Amato recalls that close to two decades ago, there was an investor-owned utility movement for a national 765-kV grid, inspired by President Eisenhower’s vision for coast-to-coast interstate highway network. But self-interest, failed partnerships and a lack of political will and capital at the time doomed the plan.
“What was being offered was ahead of its time,” Amato says. “The need wasn’t realized at that time.”
Now the pressures that once felt distant are unavoidable: soaring demand, aging assets and renewable integration. The scale of need is greater and more visible, with demand for drivers coming into alignment.
Policy changes such as Federal Energy Regulatory Commission (FERC) Order 1000 have spurred competitive transmission development, and independent system operators (ISOs) and regional transmission organizations (RTOs) are factoring 765-kV transmission into long-term plans. Although U.S. experience with the technology has been limited to date, there is substantial proof of concept: 765-kV equipment has been successfully deployed in markets from South Africa to India and South Korea. Equipment manufacturing capacity exists globally, with lead times comparable to those for 345- and 500-kV equipment.
As 765-kV projects are moving from “what if” to “how fast,” developments are springing up in many regions:

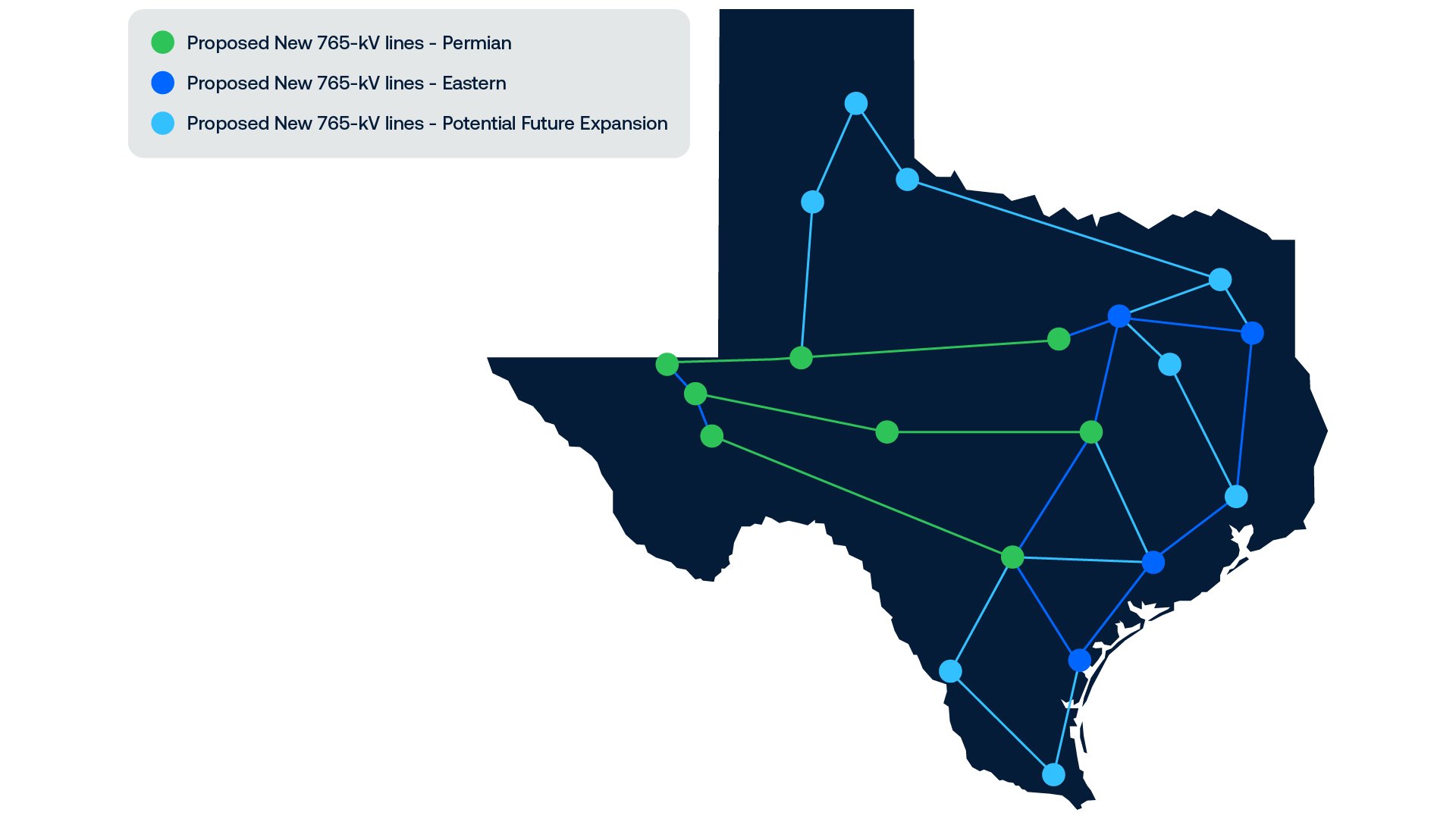

- Texas — Within the Electric Reliability Corp. of Texas (ERCOT), three 765-kV lines were approved in April. These lines and their associated upgrades have a total estimated cost of $10.1 billion, reflecting 1,255 miles of new lines expected to be placed into service by 2031. There are additional plans in development to extend the 765-kV network into other parts of the state in future phases.
- Midwest — As part of the Midwest ISO (MISO) Tranche 2.1, a power line and substation portfolio valued at $21.8 billion, a backbone of 765-kV transmission line and substation projects spanning its multistate footprint is set to be built. These projects have expected in-service dates in 2032-34.
- Mid-Atlantic — PJM Interconnection already features over 2,500 miles of 765-kV, the largest existing 765-kV network in the U.S. Because PJM territory is home to the largest concentration of data centers, and with the grid in northern Virginia experiencing substantial congestion, additional lines are planned to meet the rising demand. Specifically, 415 miles of new 765-kV transmission lines were approved earlier this year as a part of PJM’s 2024 Regional Transmission Expansion Plan (RTEP) Window 1.
- Central — The Southwestern Power Pool (SPP) Integrated Transmission Planning (ITP) 2024 portfolio includes a $1.7 billion, 293-mile greenfield 765-kV transmission line project. The 2025 portfolio is expected to include several billion dollars’ worth of 765-kV transmission line and substation projects in New Mexico, Texas, Oklahoma and Mississippi.

When utilities get guidance from ISOs and RTOs to pursue 765-kV initiatives, most do not yet have standards and specifications to guide their engineering and design efforts, Kim says.
“They need to thoroughly study those solutions,” says Kim, whose team works with utilities on transmission planning and power system analyses. “They don’t have that knowledge and experience in-house because they never had that asset class and never had to worry about it previously. Now they must examine the entire life cycle of the assets, starting from planning and moving into reliability studies, engineering, permitting and more.”
Despite the many drivers, obstacles to 765-kV transmission development remain daunting, perhaps most significantly involving permitting.
“Until a project’s permitted, it’s not real,” cautions Amato, drawing on more than two decades of experience in energy markets. “It’s like a mantra. That’s a real concern as utilities look at these massive efforts with permitting hurdles that are counterintuitive to our national security needs.”
Cost could be a notable obstacle, with some 765-kV transmission project estimates exceeding a billion dollars. Utilities, consultants and contractors are exceptionally cautious about risk. With so much on the line, organizations can be understandably nervous about the enterprise-level risk they could face.
Interstate coordination and approvals also can be a major hurdle, given states’ right to block portions of interstate lines. “That’s how things get shut down,” Amato says. “The states have the power, and if one doesn't see an incentive for their state, they can kill a necessary infrastructure project, and the ISOs and FERC won’t override it, unlike gas pipelines.”
(The Natural Gas Act of 1938 gives FERC authority to approve the siting of interstate pipelines and storage facilities. If FERC grants a certificate of public convenience and necessity, it gives developers the right of eminent domain to acquire land, overriding state or local opposition. However, federal authority for siting electric lines has historically been limited and indirect. Most siting and permitting authority was reserved for individual states, and interstate transmission lines often face resistance from states that perceive little local benefit. And although the 2005 Energy Policy Act gave FERC “backstop authority” to approve interstate electric transmission projects in federally designated National Interest Electric Transmission Corridors, this authority has rarely been used because of legal challenges and bureaucratic hurdles.)
Similarly, some states give utilities right of first refusal for competitive transmission projects. This can complicate interstate projects if one state allows a project to be bid but an adjacent state gives a different utility the right to intervene.
Political shifts can alter project trajectories as well. Changing administrations and priorities could accelerate or slow development.
Meanwhile, workforce retirements are draining the already-limited pool of builders experienced with 765-kV transmission. International partnerships could be a crucial method to leverage testing facilities, vendor networks and operational know-how.

Even amid challenges, the rising modern stakes seem to be high enough to defeat inertia and propel projects. Amato regards it as a race not just for electricity, but for strategic advantage.
“Whoever leads in power is going to lead in superintelligence and AI,” he says. “It's about having an intuitive 21st-century grid with high-voltage transmission and low-voltage distribution systems that are going to be intelligent enough to be able to withstand cyberattacks and strong enough to support technological dominance on a global scale.”
In that vision, 765-kV transmission is more than an engineering feat; it’s a pillar of national security. It is critical to maintaining energy, technology and military supremacy.
No one expects a quick build-out. Even in Texas, the timelines for the three new lines extend into the early 2030s. But if 765-kV lines are built as planned, they could set the stage for a broader network, forming a high-capacity backbone linking regions, enabling renewable power and giving the aging grid new vigor.
